“How much will my renovation actually cost? Why do builders take so long to give me a price? What happens if I go over budget?”
Most Auckland home renovations cost $2,800–$4,500 per m² in 2025 (includes GST). A typical 150m² renovation costs $420,000–$675,000 (not including temporary accommodation). Total time is 6–12 months from the first meeting to completion.
⚠️ All costs include GST unless specifically noted otherwise
The reality is simple: home renovation costs confuse Auckland homeowners because builders make the pricing process unnecessarily complicated. You deserve straight answers about what drives costs, how payments actually work, and which expenses pop up during construction.
The truth is, pricing follows a predictable pattern once you understand three core factors: your home’s location, the structural changes needed, and your finish selections. Payment stages follow construction milestones, not calendar dates. The expenses that blindside most homeowners include council fees, temporary accommodation, and structural discoveries during demolition.
For complete renovation planning guidance covering design through completion, see our comprehensive home renovation guide.
What Drives Auckland Home Renovation Costs Most in 2025?
Your renovation’s location, structural changes, and finish level account for approximately 80% of your final cost.
Location affects pricing because North Shore clients expect premium materials, while South Auckland has more competitive builder pricing. Moving walls costs a significant amount of money because engineers, council approvals, and steel beams are involved. Premium finishes add $80,000–$150,000 to standard budgets because luxury items come with luxury prices.
The Three Cost Multipliers That Matter
Location premium hits your budget hard. North Shore properties cost 15-20% more than those in South Auckland, not because builders are greedy, but because material costs differ dramatically. Central Auckland adds parking headaches and site access challenges that slow work and increase costs.
Structural complexity doubles your budget fast. Removing one wall requires the approval of an engineer, council consent amendments, and the installation of a steel beam. These changes cost $15,000–$35,000 per wall versus $2,000–$5,000 for cosmetic modifications that don’t touch the structure.
Finish selections create the biggest budget surprises. Standard pricing assumes mid-range materials. Choose stone benchtops over laminate? Add $8,000–$15,000. Want European appliances instead of standard brands? Add $20,000 to $40,000 to your kitchen budget.
Area | Cost per m² | Typical Premium | Why Higher |
Central Auckland | $4,200–$5,200 | Base rate | Access, permits |
North Shore | $4,500–$5,500 | +15% | Premium materials expected |
Eastern Suburbs | $4,800–$6,000 | +20% | High-end finishes standard |
West Auckland | $3,800–$4,800 | -10% | Lower material transport costs |
South Auckland | $3,500–$4,200 | -15% | Competitive builder market |
The Hidden Cost Drivers Nobody Talks About
Council fees vary wildly based on your renovation scope. Simple interior changes? $2,000–$5,000 in fees. Adding rooms or changing exterior walls? $8,000–$25,000 because the council requires structural assessments and neighbour notifications.
Structural engineer reports cost $3,500–$8,000 upfront, but prevent expensive construction surprises. Smart engineers identify foundation issues, load-bearing requirements, and earthquake strengthening needs before your builder starts swinging hammers.
Temporary utilities cost $2,000–$5,000 when renovation work requires the temporary disconnection of your power, water, or gas. Builders install temporary connections so work continues safely during major electrical or plumbing updates.
Storage costs add $200–$600 monthly for protecting furniture during construction. Most homeowners overlook this expense, which persists throughout the entire project timeline.
How Long Do Building Consents Take in Auckland Right Now?
Most building consents take 12–16 weeks in Auckland during 2025, plus 2–4 weeks for pre-application meetings.
What Auckland Council won’t tell you upfront: simple renovations process in 8–12 weeks when applications include complete documentation. Complex alterations involving structural changes take 12–20 weeks because council engineers review everything twice.
Heritage properties face brutal 16–26 week processing times because council officers evaluate historical preservation alongside modern building standards. Multi-level additions take 14–18 weeks due to structural complexity and mandatory neighbour consultation.

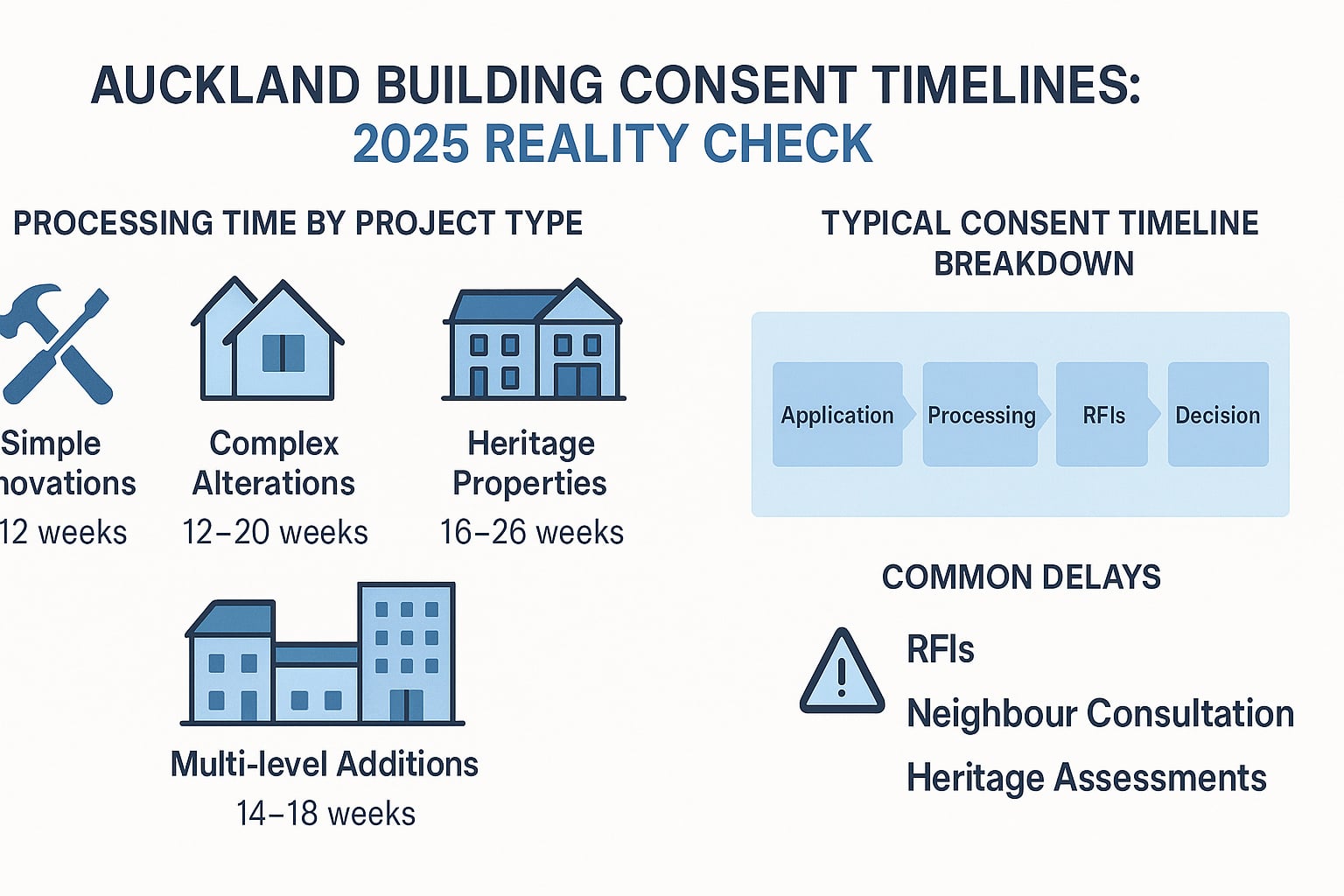

Auckland Council Processing Reality Check
Simple renovations include bathroom updates, kitchen remodels without wall changes, and cosmetic alterations. These process faster because minimal structural assessment is needed.
Complex alterations involve removing walls, adding rooms, or changing roof structures. The council demands reports from engineers, structural calculations, and detailed construction methodologies before approval.
Heritage properties must strike a balance between historical character and modern building standards. This requires specialist heritage architects and extended council review periods that test everyone’s patience.
Multi-level additions affect your home’s structural foundation and require engineering analysis, neighbour consultation, and detailed safety assessments.
Consent Timeline Breakdown (Print This)
- Pre-application meeting: 2–3 weeks to get council officers to sit down with you
- Application preparation: 3–4 weeks, coordinating architect and engineer input
- Council review: 12–16 weeks for standard processing (if you’re lucky)
- Request for Information (RFI): Adds 4–8 weeks when documentation is incomplete
- Final approval: 1–2 weeks after addressing the council’s additional requirements
Most consent delays stem from incomplete structural drawings, not council processing backlogs. Applications missing engineer stamps, compliance schedules, or construction details trigger automatic RFI responses extending approval by 4–8 weeks.
Neighbour consultation adds 2–4 weeks for boundary work or height increases. Heritage assessments add 4–6 weeks for protected properties. Plan accordingly.
What's Included in Per m² Pricing—and What Isn't?
Standard renovation pricing includes structural work, insulation, plumbing, electrical, and basic finishes. Excludes appliances, landscaping, and temporary accommodation costs.
Where builders trip up homeowners: quotes cover construction work but exclude items you buy separately. Understanding these distinctions prevents nasty budget surprises during construction.
What Your Builder’s Quote Actually Covers
✅ Included in base pricing:
- Demolition and structural work, including rubbish removal
- Plumbing and electrical rough-in with council inspections
- Insulation and interior linings meeting building code requirements
- Standard paint finishes and basic flooring installation
- Basic bathroom and kitchen fittings (no appliances)
- Building consent fees and inspection costs
❌ Almost always excluded (budget separately):
- Kitchen appliances ($8,000–$25,000 depending on brands)
- Light fixtures and ceiling fans ($2,000–$8,000 for an average home)
- Landscaping repairs from construction damage
- Temporary accommodation during major construction
- Storage and moving costs for your belongings
- Premium finish upgrades above standard allowances
Kitchen appliances create sticker shock. Basic packages cost $8,000–$12,000. Premium European brands hit $20,000–$35,000 for identical functionality. Budget wisely.
Light fixtures range from $150 basic pendants to $2,000 designer pieces. Builders install light points, leaving fixture selection to you.
Temporary accommodation costs $150–$400 nightly during phases when your home becomes unlivable. Most renovations require 2–6 months of alternative housing. Do the math.
Phase | Percentage of Total | Auckland Range | What’s Included |
Demolition & Structural | 25-30% | $105,000–$202,500 | Walls, floors, roof work |
Plumbing & Electrical | 15-20% | $63,000–$135,000 | Rough-in, compliance |
Insulation & Linings | 15-18% | $63,000–$121,500 | Gib, insulation, weatherboards |
Finishes | 25-35% | $105,000–$236,250 | Paint, flooring, fixtures |
Project Management | 8-12% | $33,600–$81,000 | Builder margin, supervision |
Should I Renovate or Build New in Auckland Right Now?
Renovation makes financial sense when your existing home needs less than $350,000 in structural work and you love your current location.
The $350,000 threshold matters because renovation costs approach new build expenses without delivering equivalent value above this amount. Below this threshold, renovation typically saves 20–30% compared to demolishing and rebuilding.

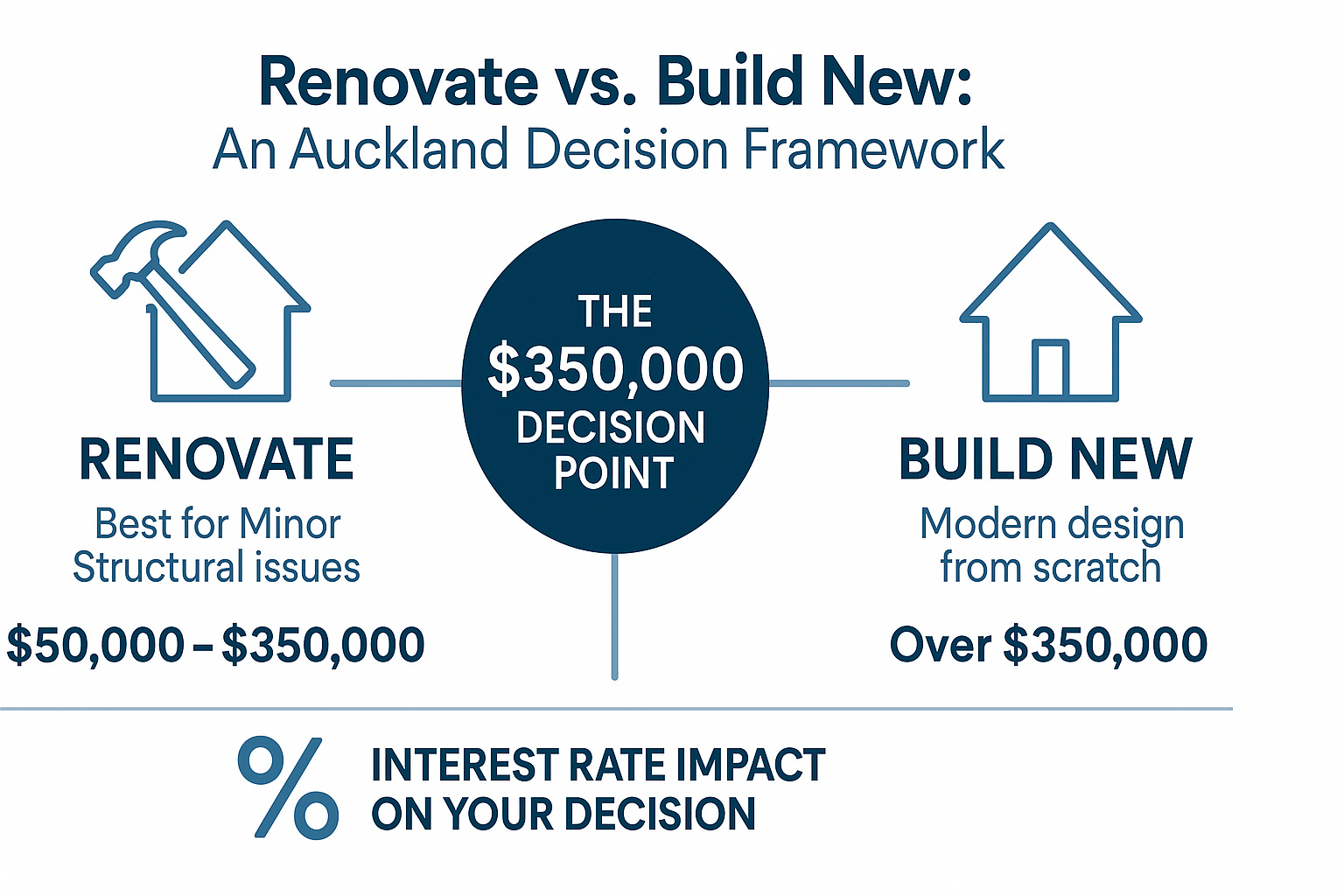

The $350,000 Decision Point
Below $350,000: Renovation delivers better value by preserving your existing structure, established gardens, and neighbourhood connections while achieving your goals.
Above $350,000: New builds often provide superior long-term value through modern construction, energy efficiency, and design flexibility that renovation cannot match.
Location preferences heavily influence this decision. Love your neighbourhood, school zones, or proximity to work? Renovation often makes sense despite the higher costs to maintain these lifestyle advantages.
Your Situation | Best Option | Why | Budget Range |
Structural issues minor | Renovate | Keep location, lower cost | $200,000–$350,000 |
Foundation problems | Build new | Avoid ongoing headaches | $800,000–$1,200,000 |
Love the location | Renovate | Neighbourhood value | $250,000–$500,000 |
Want a modern layout | Build new | Design from scratch | $800,000–$1,500,000 |
Interest Rate Impact on Your Decision Timing
Current mortgage rates of 6.5–7.5% make renovation financing more attractive than new build loans because renovation requires smaller borrowing amounts and shorter loan terms.
Refinancing strategy becomes crucial when renovation costs exceed $200,000. Homeowners who refinance before construction lock in current rates and avoid potential increases during building.
Cash versus borrowed funding affects project timing significantly. Every $100,000 borrowed at current rates costs $6,500–$7,500 annually in interest. Cash funding becomes attractive when available.
Many Auckland homeowners delay projects, hoping for lower rates. Market analysis suggests rates remain elevated through 2025. Make decisions based on project necessity, not rate predictions.
How Do Builder Payment Stages Work in Practice?
Auckland builders typically request 5–7 payments tied to completion milestones, never more than 10% upfront.
Payment schedules should work like this: each payment corresponds to completed work phases, adding measurable value to your property. This protects both you and your builder from project risks.
Builder bankruptcies often occur within 90 days of receiving large upfront payments, as cash flow problems requiring significant deposits typically indicate underlying financial instability. Avoid this risk entirely.
Standard Payment Schedule That Protects You
- Contract signing: 5–10% deposit secures materials and labour scheduling
- Demolition complete: 15–20% after site preparation and waste removal
- Frame and roof: 20–25% when structural work passes council inspection
- Plumbing/electrical rough-in: 15–20% after services installation and inspection
- Insulation and linings: 15–20% when interior surfaces reach practical completion
- Finishes 50% complete: 10–15% during painting and flooring installation
- Practical completion: Final 5–10% after defect rectification and handover
This structure ensures builders receive payment for completed work while you retain leverage for project completion and quality standards. Fair for everyone.
Red Flags in Payment Terms (Never Accept These)
❌ Danger signs to avoid:
- More than 10% deposit before construction begins
- Payment requests before corresponding work completion
- Cash-only demands without proper invoicing
- Payment schedules without specific milestone definitions
- Pressure for immediate payment without inspection time
✅ Healthy payment terms include:
- Payments tied to specific, measurable completion milestones
- Written payment schedule with dates linked to work progress
- Progress photo documentation before each payment release
- Retention amount (5–10%) held until the defects period expires
- Clear variation process for additional work requiring written approval
References from the past 6 months matter more than 5-star reviews from 2 years ago because recent references reflect current business practices, workforce stability, and project management capabilities. Ask for them.
What Happens When You Go Over Budget?
Budget overruns happen on 65% of Auckland renovations, typically adding 15–25% to original costs.
Overruns occur through four predictable categories: structural surprises during demolition, upgrade decisions made during construction, council requirement changes, and weather delays extending timelines. Knowing this helps you prepare.
Common Overrun Categories (Plan for These)
Structural surprises cost $8,000–$35,000 when demolition reveals rotten timber, foundation settlement, or dodgy previous DIY work requiring professional rectification. Pre-renovation structural inspections reduce these nasty surprises.
Upgrade creep adds $15,000–$50,000 when you choose better finishes during construction after seeing standard materials installed. This emotional decision-making happens when you visualise your completed space for the first time.
Council requirement changes cost $5,000–$20,000 when new regulations emerge during construction or inspectors identify compliance issues not covered in original consent approvals. Bureaucracy strikes again.
Weather delays add $200–$600 weekly in temporary accommodation when construction extends beyond planned timelines due to excessive rain or extreme weather. Auckland weather doesn’t follow construction schedules.
Protecting Yourself From Budget Surprises
Set aside 20% contingency funding before construction begins. This amount covers most surprise costs without requiring emergency borrowing or project delays while you scramble for additional funds.
Get fixed-price contracts with detailed variation processes requiring written approval before additional work begins. Verbal agreements during construction create disputes about cost responsibility later.
Approve all changes in writing before work starts, including material upgrades, design modifications, or additional features. Written approval prevents arguments about change authorisation and cost responsibility.
Schedule regular site meetings with photographic progress records documenting work completion and identifying potential issues before they become expensive problems requiring rectification.

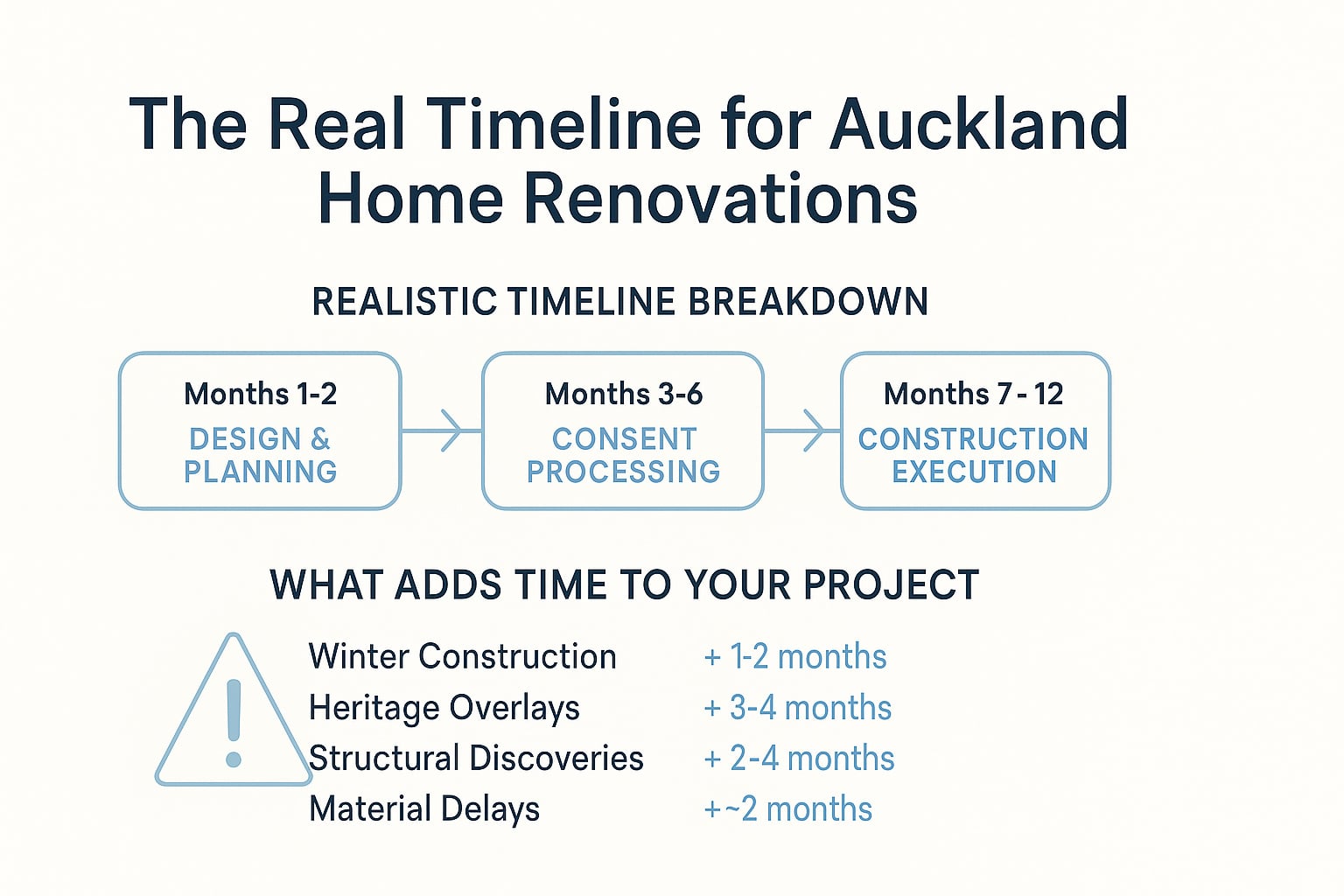

The Real Timeline for Auckland Home Renovations
Most Auckland renovations take 8–14 months total: 3–4 months for consents, 5–10 months for construction.
Timeline planning requires realistic expectations based on project complexity and seasonal factors affecting work progress. Optimistic timelines cause stress and poor decisions when reality hits.
Dust and noise from demolition persists 6–8 weeks longer than most homeowners expect due to progressive work phases, ongoing material deliveries, and finishing work continuing to generate construction disturbance.
Realistic Timeline Breakdown
Months 1–2: Design and planning phase
- Architect drawing development with multiple revisions
- Engineering input for structural requirements
- Initial builder meetings for pricing and scheduling coordination
Months 3–6: Consent processing period
- Council application preparation and submission
- Request for Information responses and documentation updates
- Final consent approval and construction scheduling confirmation
Months 7–12: Construction execution
- Demolition work (2–3 weeks including site preparation)
- Structural modifications (6–10 weeks including council inspections)
- Services installation (4–6 weeks for plumbing and electrical rough-in)
- Interior finishes (6–8 weeks for painting, flooring, and fixture installation)
What Adds Time to Your Project (Plan for These)
Winter construction adds 2–4 weeks due to weather delays, reduced daylight hours, and material delivery complications during Auckland’s wet season from June through August.
Heritage overlays extend consent processing by 4–8 weeks because council heritage advisors review applications for historical preservation compliance alongside standard building requirements.
Structural discoveries add 2–6 weeks when demolition reveals foundation issues, load-bearing modifications, or previous construction requiring engineer assessment and consent amendments.
Material delays extend timelines 1–4 weeks when supply chain disruptions affect specialty items, custom orders, or imported products with shipping complications.
Weather delays add 1–3 weeks annually based on seasonal rainfall patterns affecting exterior work, concrete pours, and material deliveries during extreme weather events.
Representative Example: 150m² Renovation in Mount Eden
Timeline: 11 months from first meeting to moving back in
Initial budget: $550,000
Final cost: $612,000 (11% overrun – typical)
Key decisions: Fixed-price contract with 20% contingency fund saved the day
Major surprise: $18,000 foundation strengthening discovered during structural work
Lesson learned: Structural pre-inspection would have identified foundation issues, preventing construction delays and relationship stress
Month-by-Month Reality Check
Months 1-2: Design development with $15,000 invested in architectural drawings, structural engineering, and building consent preparation. Three builders provided quotes ranging from $520,000 to $580,000.
Month 3: Council application submission with $8,500 in consent fees and processing charges. Pre-application meeting identified potential heritage concerns requiring additional documentation and delays.
Months 4-6: Consent processing with one Request for Information requiring structural calculation updates. Temporary accommodation arrangements confirmed at $2,400 monthly cost adding budget pressure.
Month 7: Construction commencement with demolition revealing foundation settlement requiring immediate engineer assessment and additional strengthening work costing unexpected $18,000.
Months 8-10: Major construction phase with monthly progress payments following milestone completions. Two weather delays extended framing work by 10 days, adding accommodation costs.
Month 11: Interior finishes installation and practical completion with final payment after defect rectification and council Code Compliance Certificate issue.
The project finished $62,000 over initial budget due to foundation strengthening ($18,000), finish upgrades during construction ($28,000), and extended temporary accommodation ($16,000). The 20% contingency fund covered overrun costs without requiring additional borrowing or family stress.
Planning Checklist (Print This)
Before You Start Your Renovation:
- Commission structural pre-inspection report from qualified engineer ($2,000 investment saves $20,000+ surprises)
- Secure fixed-price building contract with detailed variation process (your financial protection)
- Establish 20% contingency fund separate from main renovation budget (non-negotiable safety net)
- Arrange temporary accommodation for entire construction period (don’t underestimate this cost)
- Lock in mortgage interest rates before construction begins (rates aren’t dropping soon)
- Obtain three detailed builder quotes with identical scope specifications (apples-to-apples comparison)
- Verify builder insurance, licensing, and Master Builder membership status (your legal protection)
During Construction Management:
- Schedule weekly site meetings with photographic progress documentation (evidence prevents disputes)
- Require written approval for all variations before work commencement (no verbal agreements)
- Inspect completed milestones before releasing staged payments (you control the money, you control quality)
- Track actual costs against budget with regular financial reviews (knowledge prevents nasty surprises)
- Document construction delays with causes and impact assessment (accountability matters)
- Maintain communication log with builder for dispute prevention (paper trail protects relationships)
- Review Code Compliance Certificate requirements before practical completion (final hurdle preparation)
Frequently Asked Questions
Never pay more than 10% of the total contract value as deposit, and only after signing comprehensive written contracts with detailed specifications and payment milestones. Larger deposits signal financial problems.
All payment increases must be approved variations documented in writing before work begins. Never agree to verbal payment requests or scope changes during construction.
Use fixed-price contracts, maintain 20% contingency funding, commission structural pre-inspections, and require written approval for all changes. These four steps prevent most financial disasters.
Begin builder selection 2–3 months before planned construction start dates to allow proper due diligence, quote comparison, and contract negotiation without time pressure.
Underestimating total project timeline and failing to budget for temporary accommodation costs throughout the entire construction period. This oversight costs thousands monthly.
Compare three detailed quotes from licensed builders and verify costs fall within $500 per square metre of each other for identical scope specifications. Major variations signal problems.
Verify comprehensive insurance coverage and Master Builder membership before signing contracts. These protections provide legal recourse and financial compensation for abandoned projects.
Market analysis suggests rates remain elevated through 2025. Make decisions based on project necessity and family needs rather than rate predictions that might not materialise.
IntelliDesign Homes connects Auckland homeowners with transparent pricing processes and realistic timeline expectations through over a decade of local building experience, helping families navigate renovation decisions confidently with fixed-price contracts and comprehensive project management.
Summary: Your Renovation Cost Action Plan
Understanding how renovation costs work protects your investment through informed decision-making and realistic budget planning. The pricing process becomes transparent when you know location premiums, structural complexity factors, and finish level impacts on total costs.
Payment stages follow construction milestones, not calendar dates, with healthy terms requiring no more than 10% upfront and retention amounts held until defect periods expire. Hidden expenses stop surprising you when you budget for council fees, temporary accommodation, and structural discoveries upfront.
Your renovation success depends on choosing builders who explain their pricing clearly, honour milestone payment schedules, and deliver projects within agreed timelines and budgets without the runaround that frustrates most homeowners.
Key action items include commissioning structural pre-inspections, budgeting 20% contingency funding, securing fixed-price contracts, allowing realistic consent timelines, and planning temporary accommodation throughout construction periods. These steps prevent the financial disasters affecting 65% of Auckland renovations.
Conclusion
Home renovation costs work through clear, predictable processes when you understand what drives pricing, how payments align with construction progress, and which expenses emerge during different project phases. Auckland homeowners who master these fundamentals avoid the budget overruns and timeline surprises that create family stress and financial strain.
The pricing process becomes straightforward when you recognise location premiums, structural complexity costs, and finish level impacts on your total investment. Payment stages protect your interests through milestone-based releases rather than upfront deposits that create financial risk. Hidden expenses become manageable when you plan for council fees, accommodation costs, and construction discoveries before they occur.
Your renovation deserves the confidence that comes from working with builders who eliminate pricing mysteries, honour their payment commitments, and deliver projects meeting your timeline and budget expectations. Stop worrying about costs, payment timing, and unexpected expenses that can derail your renovation dreams. Book your FREE consultation with IntelliDesign Homes today and get the transparent pricing breakdown, clear payment schedule, and honest timeline assessment your Auckland renovation project needs to succeed.
